Hadianto, Usman (2025) Analisis Efisiensi Kombinasi Penggunaan Alat Berat Pada Pekerjaan Galian dan Timbunan di Proyek Pembangunan Jalur Lintas Selatan Lot. 3 Pantai Serang - Sumbersih. Undergraduate thesis, UPN Veteran Jawa Timur.
![]() |
Text (Cover)
21035010053.-Cover.pdf Download (8MB) |
![]() |
Text (Bab 1)
21035010053.-Bab 1.pdf Download (1MB) |
![]() |
Text (Bab 2)
21035010053.-Bab 2.pdf Restricted to Repository staff only until 20 June 2027. Download (7MB) |
![]() |
Text (Bab 3)
21035010053.-Bab 3.pdf Restricted to Repository staff only until 20 June 2027. Download (2MB) |
![]() |
Text (Bab 4)
21035010053.-Bab 4.pdf Restricted to Repository staff only until 20 June 2027. Download (14MB) |
![]() |
Text (Bab 5)
21035010053.-Bab 5.pdf Download (435kB) |
![]() |
Text (Daftar Pustaka)
21035010053.-Daftar Pustaka.pdf Download (982kB) |
![]() |
Text (Lampiran)
21035010053.-Lampiran.pdf Restricted to Repository staff only Download (1MB) |
Abstract

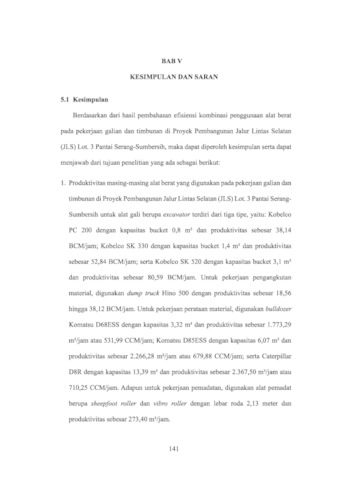

In earthworks with difficult terrain conditions and extreme topography that make the earthwork process less than optimal, adequate equipment is needed with the right implementation method. An efficient heavy equipment management system is needed to complete a earthwork on time. This study aims to analyze the productivity and efficiency of the combination of heavy equipment used in excavation and heap work. Heavy equipment productivity is calculated based on cycle time in the field and heavy equipment requirements are calculated based on the volume of the weekly plan. After that, an efficient combination of heavy equipment planning is carried out for excavation and heaping work. The method of calculating heavy equipment needs uses a theoretical approach, with cycle time adjustments based on operational conditions in the field. Efficiency analysis and heavy equipment selection are carried out based on the idle time of the smallest heavy equipment. The Optimal cut-fill Pairing and Sequencing (OPS) method is used to create a scheme of excavation and heaping work. The results of the analysis showed that the most efficient combination of heavy equipment used in excavation work of 14,467.66 BCM every week was 4 units of Kobelco PC 200 excavators, 2 units of Kobelco SK 330 excavators, and 10 units of Hino 500 dump trucks. Meanwhile, in the backfill work of 5,423.96 CCM every week, 1 unit of Komatsu D68ESS bulldozer, 1 unit of Sakai SV512TF sheepfoot roller, and 1 unit of Sakai vibro roller SV512TF are needed. This combination is chosen based on capacity, productivity, and synchronization between heavy equipment to avoid idle time. With proper planning, high work efficiency, operational cost savings, and project completion are achieved according to the set schedule.
Item Type: | Thesis (Undergraduate) | ||||||||
---|---|---|---|---|---|---|---|---|---|
Contributors: |
|
||||||||
Subjects: | T Technology > TE Highway engineering. Roads and pavements | ||||||||
Divisions: | Faculty of Engineering > Departement of Civil Engineering | ||||||||
Depositing User: | Usman Hadianto | ||||||||
Date Deposited: | 20 Jun 2025 07:27 | ||||||||
Last Modified: | 20 Jun 2025 07:27 | ||||||||
URI: | https://repository.upnjatim.ac.id/id/eprint/38869 |
Actions (login required)
![]() |
View Item |
